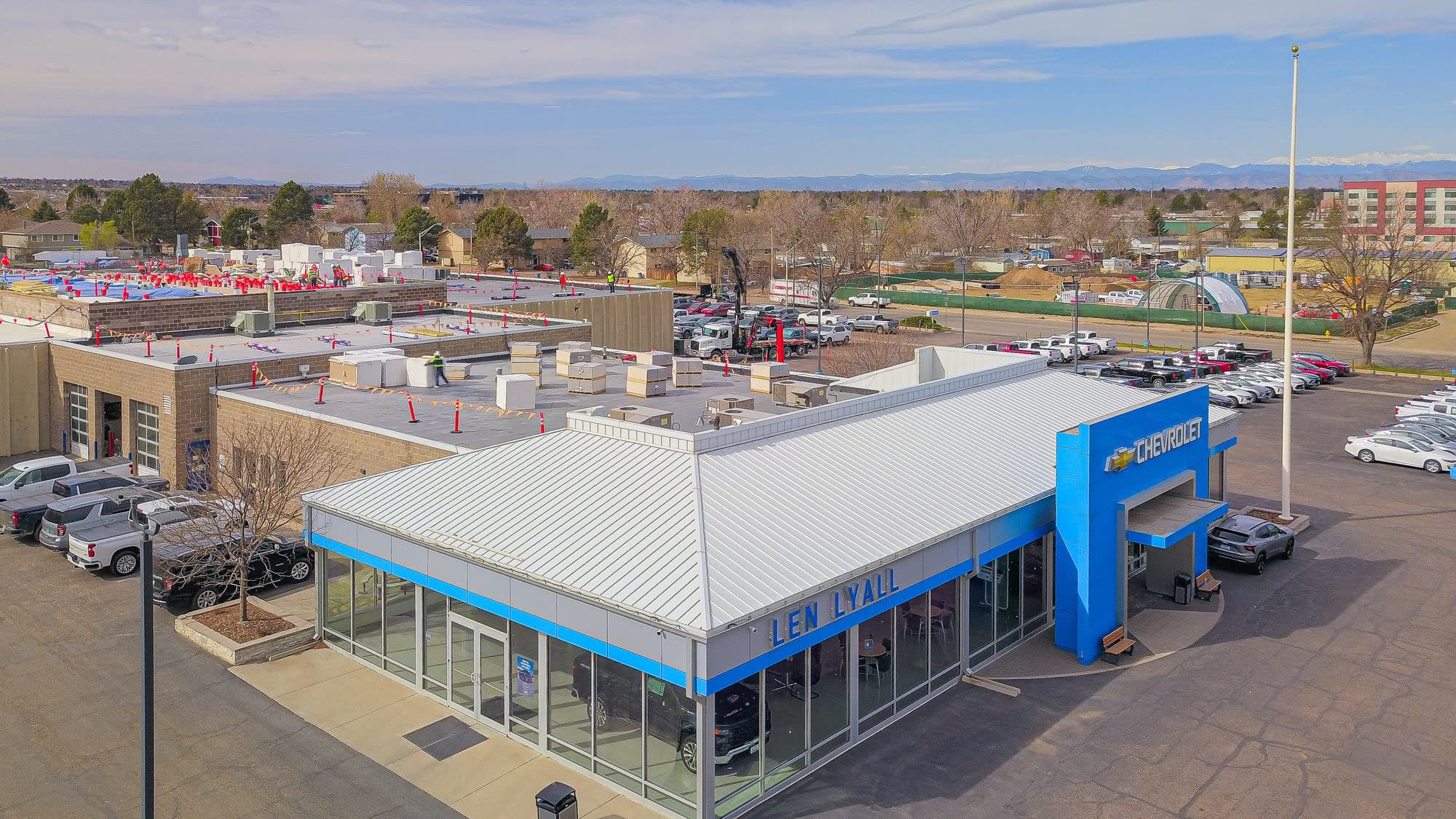

This is an auto dealership campus re-roof in Aurora, Colorado — $1.4 million in scope across 600 squares of roof and three different roofing systems matched to three different building types. The dealership stayed fully operational for all eight weeks of the install. Customers bought cars, mechanics turned wrenches, the body shop pulled cars in and out — while our crew was on the roof above them in full PPE on a coordinated daily plan. The high-traffic customer-facing sections we worked after business hours so the showroom and the front drive lanes were never under a falling-debris zone during sales hours.

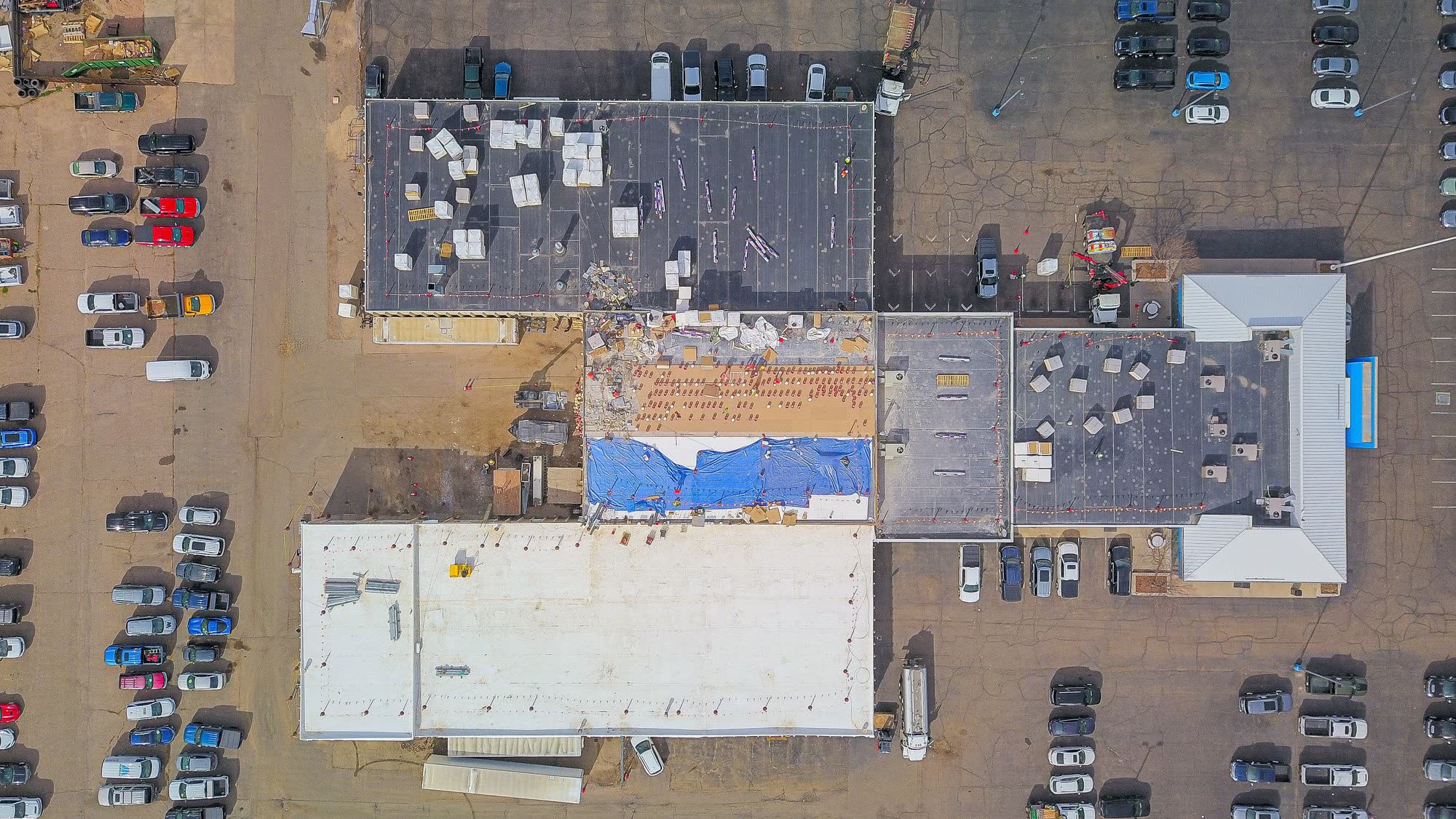

Most commercial portfolios are one-system jobs — everything's TPO, or everything's standing seam, or everything's modified bitumen. This dealership wasn't. The campus had three distinct building types, each with its own structural envelope and its own optimal roof system. Rather than force one system across all three, we scoped the right material for each.
Three crews, three foremen, three closeout packets — one project manager owning the schedule, the safety brief, and the weekly check-in with the dealer's facility lead.
The hardest part of this project wasn't the roofing. It was not interrupting the business. An auto dealership runs on traffic flow: customers walk into the showroom, take a test drive, write the deal, and drive home. Service customers drop their car at the service drive, get a loaner, come back at the end of the day. Anything that pinches that flow pinches revenue immediately.

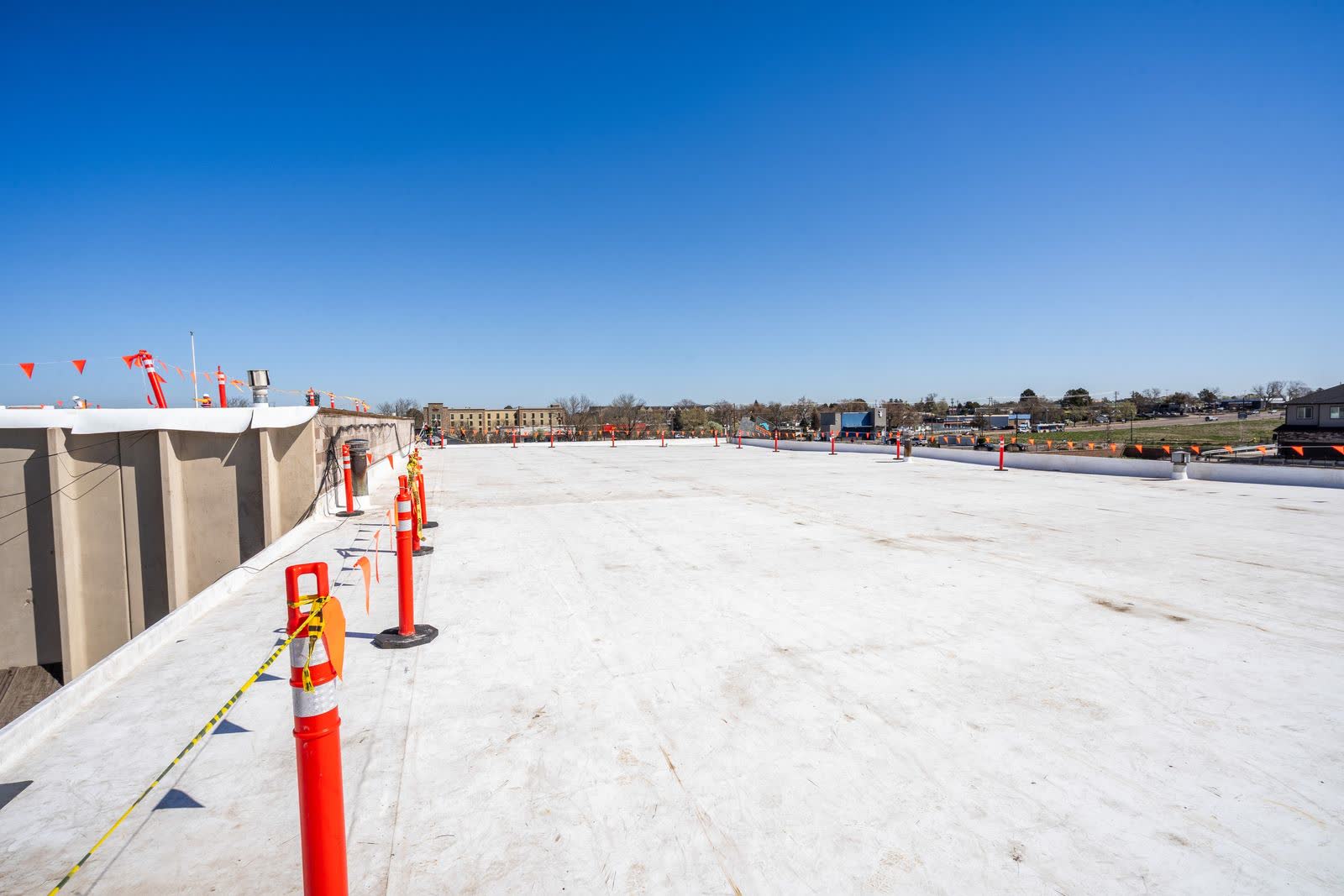

For the high-traffic customer-facing sections — the showroom standing seam install, the service drive overhead, the front of the body shop — we worked after business hours. Demo, panel staging, fastener install, cleanup, all completed at night so the showroom opened in the morning to a clean campus and customers had no idea a roof project was happening overhead. Lower-traffic back-of-house and rear elevation sections we worked daytime with a phased material-delivery plan that kept the customer parking front lots completely off the staging map.

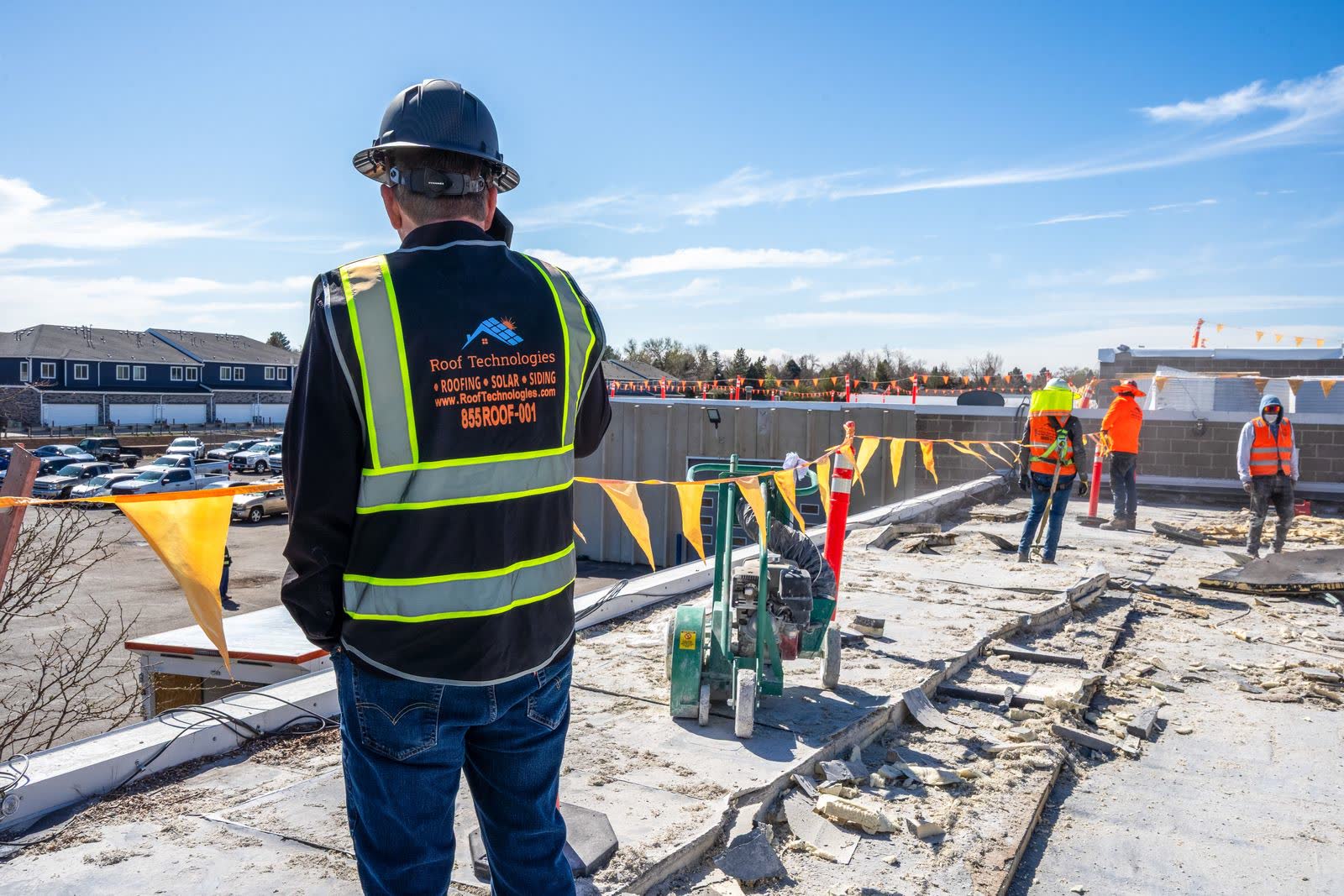

Every morning started with a brief: where is each crew working today, which bay needs to stay open, which side of the lot is roped off, where are the dumpster swaps and the material deliveries scheduled, and what is the weather doing. We ran with a crew of 8 to 12 in full PPE and RT-branded safety vests, with daily safety briefs led by the foreman before anyone went up on the roof.

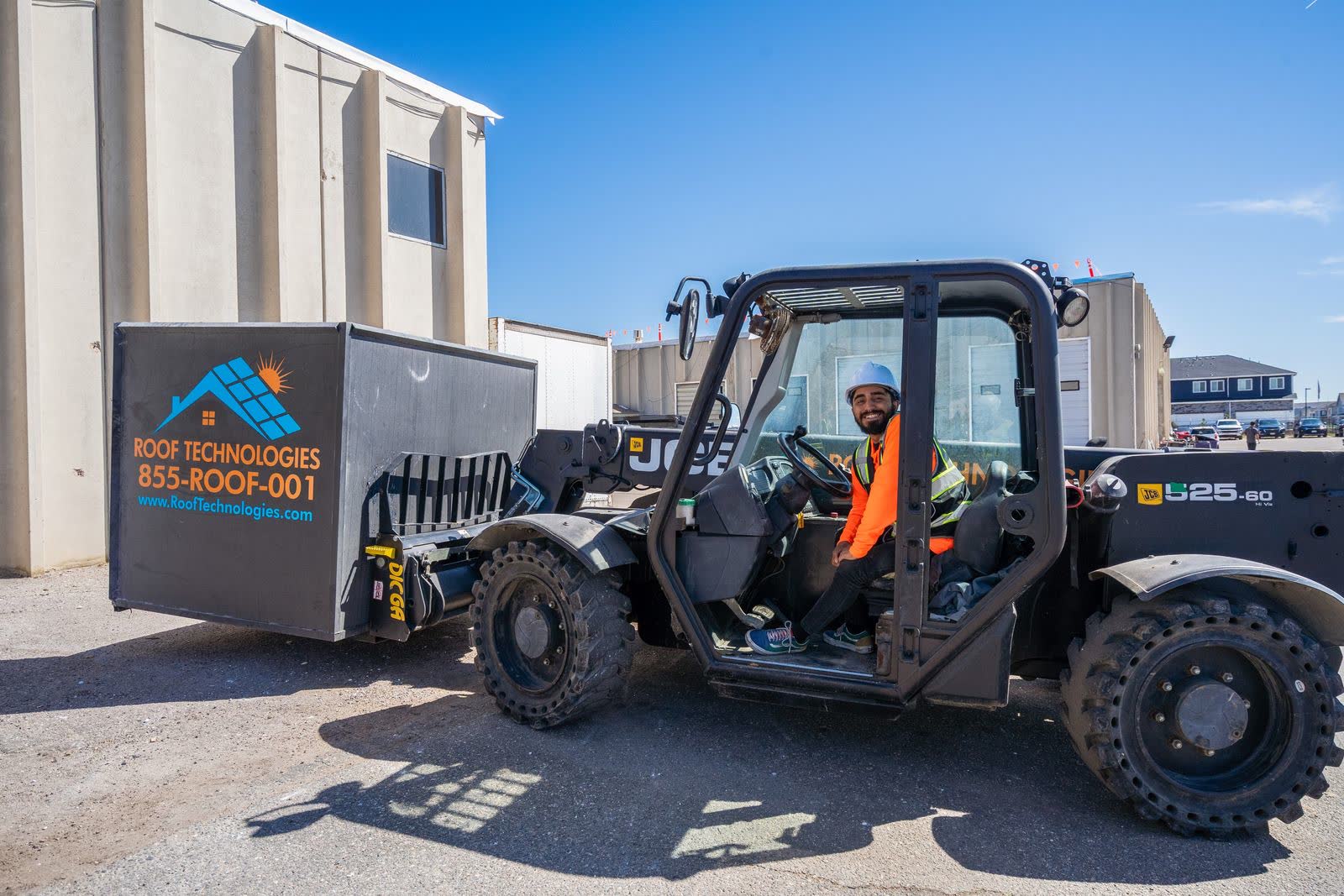

We brought our JCB telehandler and a fleet of RT-branded staging boxes to this site. Every material movement — insulation board off the truck, TPO rolls up to the roof, standing seam panels lifted to the showroom slope, demo debris down to the dump trailer — happened off our equipment, not the dealership's lots. That's not a small detail on an active dealership campus. Customer parking is revenue. The lanes leading into the service drive are revenue. Body shop bay access is revenue. We staged off our trailers and our boxes in the smallest footprint that would let us run the work, and we cleaned that footprint down at the end of every day so the lot was sellable in the morning.

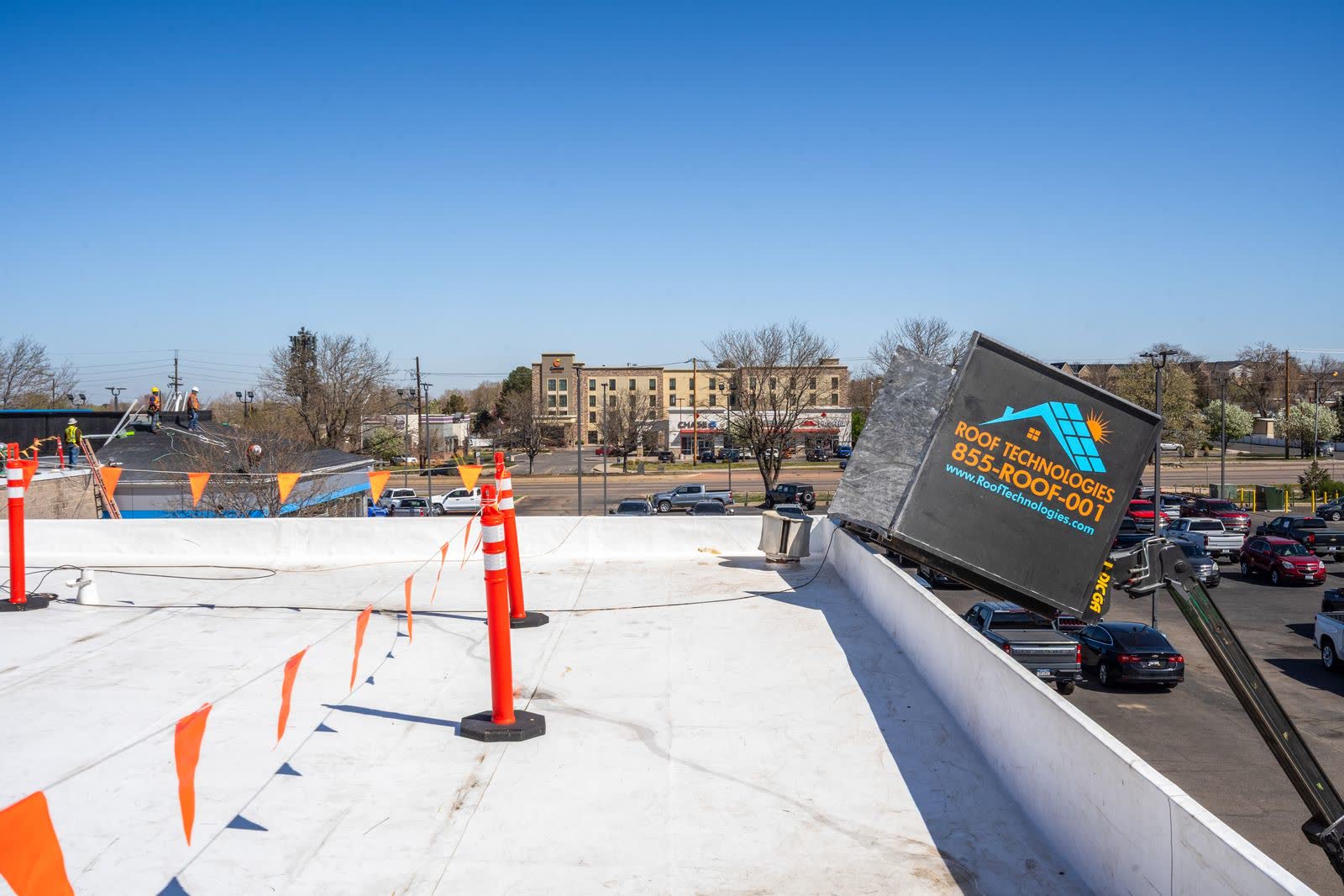

The RT-branded staging boxes do double duty: weatherproof material storage, overnight protection for new polyiso and standing seam panels, and a visible marker on the property that says this is a professional commercial roofing job in progress. In the project photos, you can see the 855-ROOF-001 on the side of one of those boxes as we craned it up onto the roof.
The project was funded through an insurance claim. On a $1.4M scope with three different roof systems, claim documentation is its own line item of work. We documented every building separately: pre-tear-off photos of insulation moisture and membrane condition, deck-condition records during tear-off, code-upgrade scope for items the original adjuster missed (drip edge, ice-and-water at metal-to-flat transitions, fastener pattern updates), and post-install photo records of the new systems. Supplements went to the carrier in writing, building by building, with photo records attached. The dealership owner closed out with three manufacturer warranties (one per system), an RT workmanship warranty, and a single closeout binder organized building-by-building.

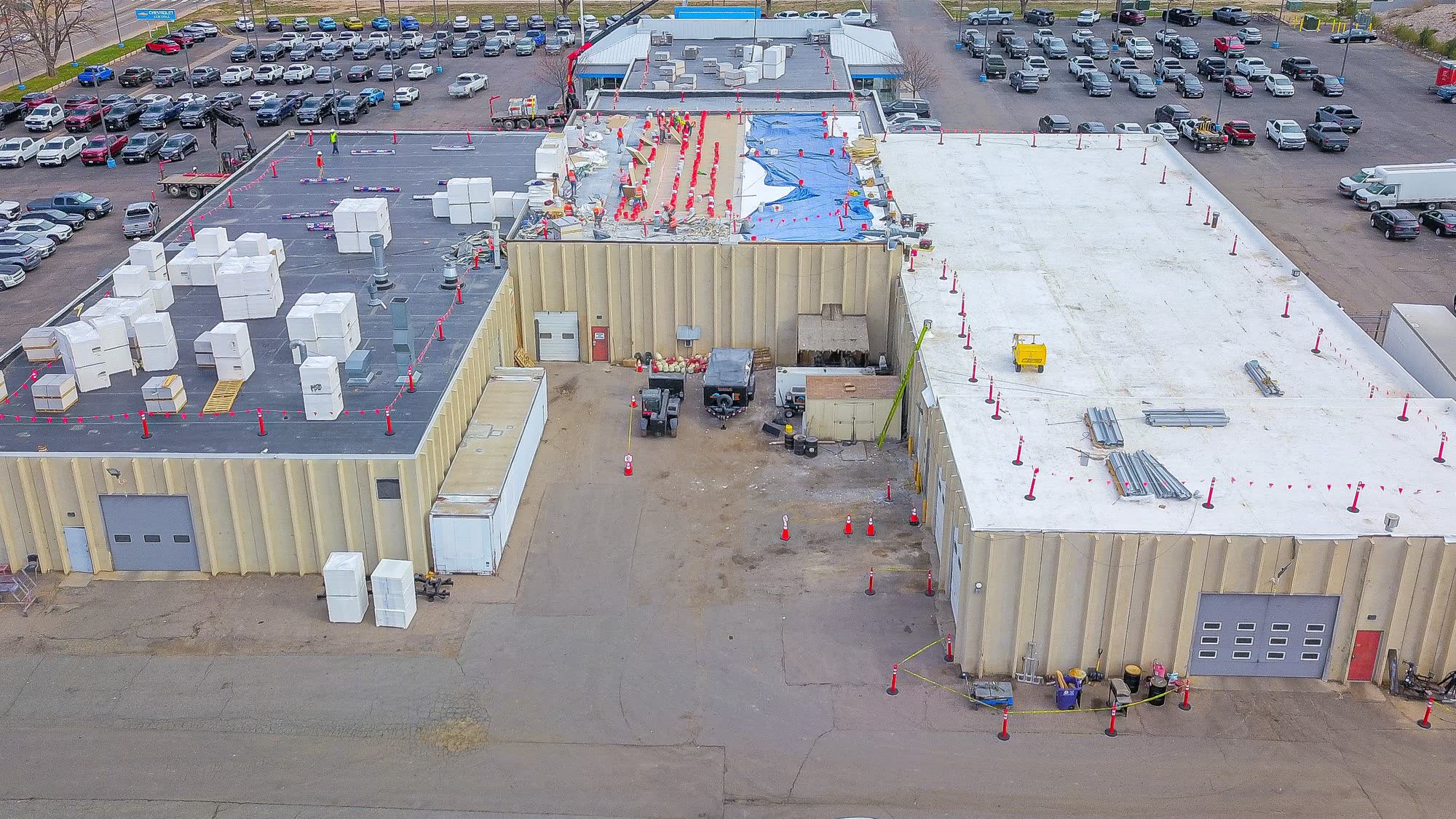

A campus this size with three different systems doesn't run in a single sequential pass — that would have stretched to four months. The only way it lands in eight weeks is by running the systems in parallel, with each crew owning its own building and the project manager running cross-crew coordination, material delivery, and the dealership communication.
By Week 5 we had two and sometimes three crews running in parallel, with a foreman on each building and the project manager moving between them all day. That's the operational pattern that makes mixed-system commercial campuses work without dragging the timeline.
"We worked after hours" is a phrase a lot of contractors use loosely — it usually means a couple of late-evening visits a week to deal with something noisy. On a $1.4M dealership project it has to mean something more disciplined than that.
For the customer-facing scope on this campus — the showroom standing seam install, the front of the body shop, the service drive overhead — we ran a dedicated night-window crew from late afternoon through early morning, with portable LED light towers staged on the lot after closing and a foreman dedicated to the night sequence. Before sales opened in the morning the lot was swept, debris was hauled, the staging footprint was condensed back to our trailers and boxes, and the daytime crew picked up at the back-of-house. There was a 6:30 a.m. handoff every workday so nothing fell through the gap between the two windows.
Daytime work continued in parallel on the back of the body shop, the storage building, and the rear elevations of the service bays — areas that weren't on the customer's path through the campus. Mixing day and night windows on the same project is what kept the dealership fully open during sales hours all eight weeks.
Most commercial campuses we walk are over-simplified by previous bidders — the contractor proposes one system across the whole property because it's easier to bid and easier to install, even when the buildings clearly don't all want the same answer. That's how a flat-roof contractor ends up putting TPO on a pitched showroom (it always leaks at the transition), or a metal contractor ends up trying to run standing seam over a building whose deck and slope can't carry it.
On a mixed-use commercial campus, the right scope is almost always system-per-building. The right contractor for the job is the one with crews trained on each system in-house — not one specialist sub-renting the rest of the work to other companies. And the right project management is a single PM running multiple foremen, not a separate point of contact per building. If your campus is sitting on aging single-ply, an aging standing seam, or a mix of both, that's the conversation we start with.
Standing seam on the showroom, white TPO with tapered insulation on the service bays and body shop, shingles on the storage building. Three roof systems running on three crews under one project manager, on an operational dealership campus, with high-traffic areas worked after hours so the customer-facing flow never stopped. Eight weeks, $1.4 million in scope, zero days closed. That's a commercial mixed-system re-roof done right.
Concealed-fastener metal panels with hidden clips and Kynar 500 PVDF finish. No exposed screws on the field. A 50-year roof on the building that defines the brand from the street. Metal Roofing →
White TPO single-ply with heat-welded seams over an engineered tapered polyiso insulation system. Eliminates ponding, drops summer cooling load, and carries a long manufacturer warranty. Commercial Roofing →
Architectural laminate asphalt shingles on the residential-style pitched storage building — right-cost match for the building type and a clean visual transition to the surrounding neighborhood. Asphalt Shingles →
Three crews, three foremen, three closeout packets — one project manager owning the schedule, the safety brief, and the weekly check-in with the dealer's facility lead. Mixed-system commercial campuses are what RT runs.
If your dealership, retail center, industrial facility, or commercial multi-building campus is sitting on aging single-ply, we can walk the roof, pull a moisture map on the existing insulation, write a clean scope for the re-roof, and execute the work with the building fully operational. Every material movement happens off our equipment, every day starts with a safety brief, and every building gets its own closeout packet at the end. If you're an owner or facility lead scoping a TPO re-roof, we can put a written scope in your hands.
We'll walk your buildings, pull a moisture map on the existing insulation, document the condition for your records or your carrier, and put together a written scope with a clear membrane, insulation, and detailing plan — per building. Free, no obligation.
